From Lab To Market: The Role of the Pilot Production Run

Pilot Production Run

How to plan and execute a pilot run to validate tooling, assembly processes, and Quality Control before committing to mass production.

Translating prototype performance into repeatable production requires a methodical pilot production run that focuses on validating the manufacturing process rather than the product design. A properly executed pilot production run surfaces tooling weaknesses, assembly bottlenecks, and quality-control gaps under real cycle times and operator conditions, reducing the likelihood of costly rework when volume starts.

You will find in this article tips to define pilot objectives, selecting pilot quantity and production lines, and preparing operator training, together with a metrics-driven methodology for measuring First Pass Yield, cycle time, scrap rate and process capability. It also lays out pragmatic tests for validating tooling, jigs, fixtures and die life under production loads, plus structured steps to finalize work instructions, quality control plans, traceability and corrective actions based on pilot feedback.

Key Takeaways

Pilot production run
Pilot production run demonstrating engineering validation and quality control in product design.
  • Confirm manufacturing capability before committing to volume
  • Define pilot size, production line, footprint and training
  • Measure FPY, takt time, cycle time, scrap and capability
  • Stress test molds, fixtures and tooling for wear
  • Lock down work instructions, inspection plans, traceability links
  • Use formal Go/No‑Go gates and regulatory release checklists
  • be familiar with the PPAP and the R@R concepts

Validate Manufacturing Processes Not Product Design

Pilot objectives must target manufacturing process validation, not product concept checks.

Define measurable outcomes for equipment setup, operator procedure adherence, and inspection gating. Use the pilot run to validate tooling, assembly processes, and quality control before committing to mass production.

Set numerical targets up front, such as for example:

  • aim for process capability Cpk ≥ 1.33 for critical dimensions
  • reduce defects toward Six Sigma guidance of 3.4 DPMO where feasible.
  • specify a target initial pass yield (IPY) such as ≥95% for noncritical assemblies.
  • Include acceptable scrap rates and cycle time windows tied to takt time.

Takt Time definition: in lean production, Takt Time is the calculated pace at which a product must be completed to satisfy customer demand. It essentially acts as the “heartbeat” of the production process, aligning manufacturing speed with the rate of customer orders. Takt time is determined by the simple formula: \(\text{Takt Time} = \frac{\text{Total Available Production Time}}{\text{Total Customer Demand for that Period}}\). The primary goal of establishing a takt time is to perfectly match production output with customer requirements, thereby minimizing waste through overproduction or underproduction and ensuring a smooth, continuous workflow. This key lean manufacturing metric is not a measure of how long it takes to produce a single unit (that’s cycle time), but rather the rhythm that the production system must maintain to meet its commitments.

Factory pilot line
Factory pilot line showcasing advanced engineering processes in consumer electronics production.

Typical process objectives:

  • Confirm machine repeatability under production cadence.
  • Validate assembly sequence and torque/force windows.
  • Prove inspection repeatability and throughput.

Each bullet shall become a discrete test with pass/fail criteria and measurement method.

Use established sampling and acceptance schemes such as ANSI/ASQ Z1.4 for lot sampling and classify defects by critical, major, minor severity. For critical defects set AQL = 0; for major items consider AQL 0.65–1.5 depending on risk. Capture run-length data to support Weibull or life estimates for tooling and fixture wear.

Weibull distribution in manufacturing validation: the Weibull distribution is a continuous probability distribution that is widely used in reliability engineering to model the time until failure of a component or system. Its strength lies in its flexibility, which is defined by its key parameters:

  • Shape parameter (β or k): this is the most crucial parameter as it indicates the nature of the failure rate over time.
    • β < 1: suggests a decreasing failure rate, often indicative of “infant mortality” where early failures are common due to manufacturing defects or initial issues.
    • β = 1: indicates a constant failure rate, characteristic of random failures during the useful life of a product.
    • β > 1: points to an increasing failure rate, signaling wear-out failures as the product ages.
  • Scale parameter (η or λ): also known as the characteristic life, represents the time at which 63.2% of the population will have failed. It essentially stretches or compresses the distribution along the time axis.
  • Location parameter (γ): this optional third parameter represents a failure-free period. If it’s greater than zero, it indicates a period of time during which no failures are expected to occur.

For more details, see our article specifically on this topic:

Product life failure curve
See alsoUnderstanding the Bathtub Curve & Product Life Failure
►

Collect a focused dataset during the trial and map it to decision metrics. The table below summarizes typical pairings.

ProcessMetricAcceptance
Injection moldingDimensional Cpk≥1.33
Assembly torqueTorque deviation (SD)≤5% of setpoint
InspectionInitial pass yield≥95%

Document objectives, measurement plans, and exit criteria in a pilot protocol signed by both manufacturing and quality together. Include traceability requirements and required data fields for each part number collected.

Tip: require a minimum run length that produces at least 30 independent samples per critical characteristic to support basic capability analysis.

Tip: check with your company rules and domain authority if validation samples shall be kept and for how long.

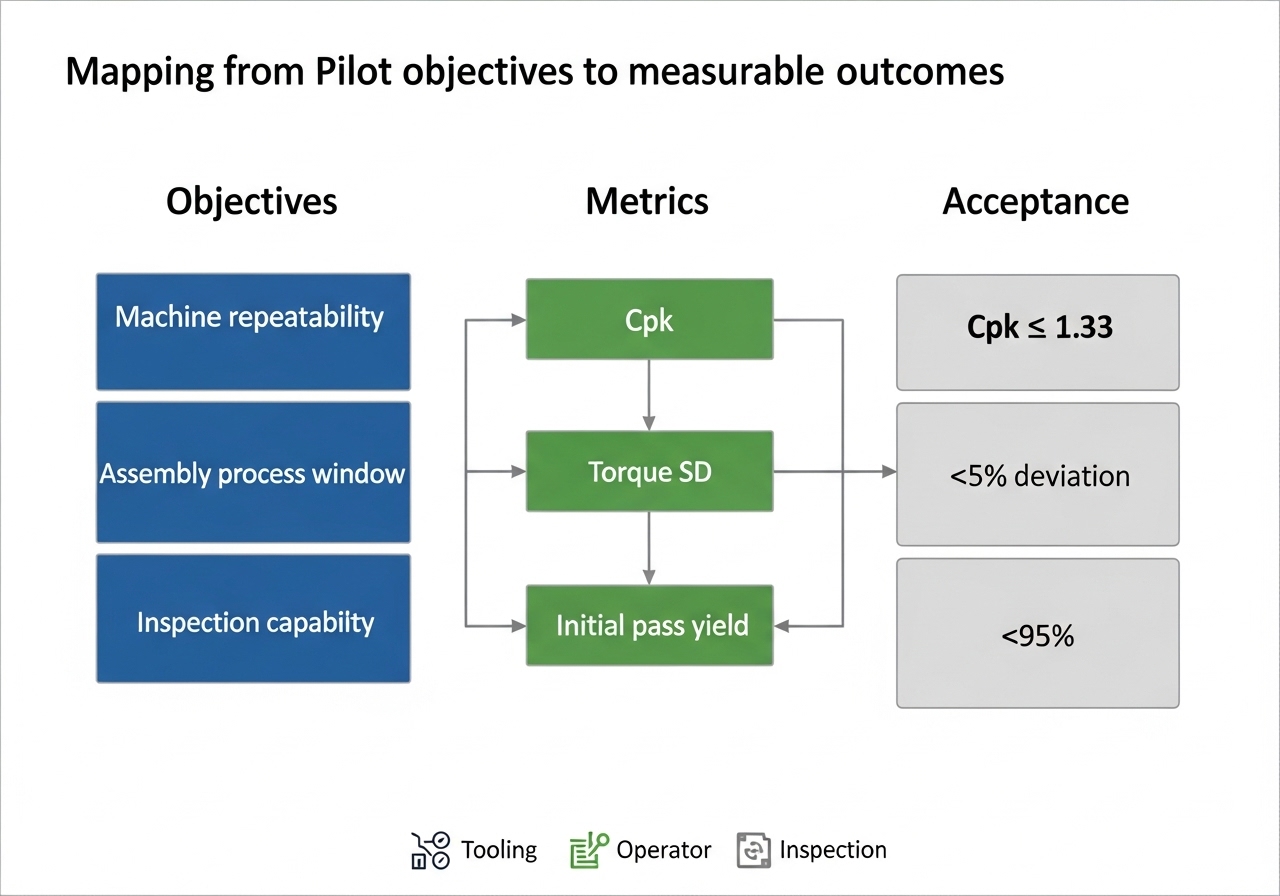

Flowchart
Flowchart for aligning pilot objectives with measurable outcomes in product design.

Planning the Pilot Run

Assembly plant
Cross-functional collaboration in a modern assembly plant for innovative product design.

Define the pilot batch count based on validation goals and downstream constraints; common industry practice sets pilot batches between 100–1,000 units to exercise tooling and logistics under production-like cadence. Select quantity to produce statistically meaningful failure modes while limiting scrap and inventory cost.

Pilot runs also bring their own manufacturing terms and acronyms, such as PPAP, FAI and Cpk, which should be defined in the release plan.

Choose the production line using clear criteria: equipment match, takt time capability, and operator skill availability. Use an ordered checklist to make the decision reproducible:

  1. Match core equipment and cycle time
  2. Confirm material flow and fixtures
  3. Validate inspection points and traceability

Compare dedicated pilot cell versus using the target production line to decide layout and resource allocation.

OptionProsCons
Dedicated pilot cellControlled variables, easy observationNon‑identical equipment
Target production lineTrue process conditionsDisrupts volume output

Use the table to brief stakeholders and capture trade offs.

Design the shop layout to preserve material flow, ergonomics, and measurement points; place SPC gates where defects first appear. For medical device regulatory compliance, process validation guidance commonly expects at least three consecutive successful batches during performance qualification. Train operators on takt time, defect recognition, and corrective action initiation before the pilot run.

Implement a competency checklist, hands‑on assessments, and live coaching during initial shifts.

Tip: require operators to complete a timed assembly trial and a quality audit score of ≥90% prior to unsupervised work. Capture all training records and link operator IDs to production lots for traceability.

Establish a ramp schedule with controlled increases in run length and inspection frequency; begin with 100% inspection for early samples, then transition to sampling plans when stability is shown. “Run it like production” is a useful dictum: record cycle times, first pass yield, and downtime minutes to build the process baseline for subsequent decisions.

Key Validation Metrics

Factory assembly line
Inspection and quality control in pcba manufacturing on an assembly line.

Validation during a pilot run focuses on four measurable outputs:

  • initial pass yield
  • cycle time
  • scrap rate
  • and process capability.

Each metric quantifies a different failure mode and together they reveal process health. Consistent measurement methods must be documented before data collection starts.

Use a clear formula for initial pass yield: \(IPY = \frac{Good Units}{Total Units}*100%\)

Typical benchmarks include consumer electronics aiming above 95% and automotive components routinely targeting above 99% single-pass acceptance.

Cycle time measurements separate value-added time from wait and setup. Track average, median, and outliers and compare against takt time or customer cadence. Useful collection methods include time studies, automated sensor timestamps, and cycle-time histograms.

IndustryTarget IPY (%)Target CpkTarget Scrap Rate (%)
Consumer electronics≥95≥1.33<2
Injection molded plastics≥98≥1.33<1
Medical devices≥99≥1.67<0.1
Automotive (PPAP)≥99.5≥1.67<0.5

Process capability uses standard statistical formulae to relate spread versus tolerances: \(C_{pk} = \min\left(\frac{\bar{X}-LTL}{3\sigma},\frac{UTL-\bar{X}}{3\sigma}\right)\). Typical estimation requires a run of at least 30 samples, with 100 samples giving tighter confidence bounds for Cpk calculations.

Use metric trends from the pilot run to set release gates, corrective action triggers, and control limits. From Lab to Market pilot run to validate tooling, assembly processes, and quality control should reference these numbers when defining go/no-go rules.

Tip: flag any batch with declining IPY or Cpk below target for immediate containment and root cause analysis.

Technical diagram

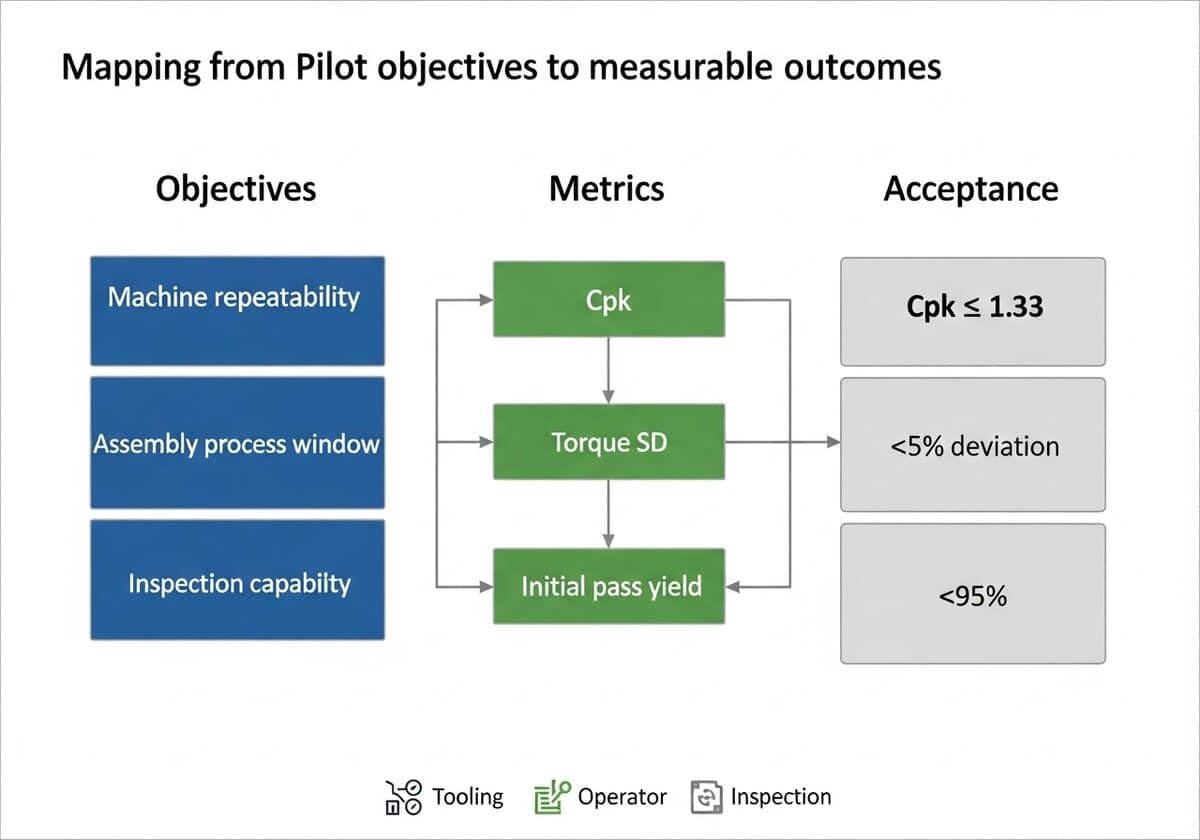

Analysis of pilot batch performance metrics through fpy, scrap rate, and cpk values.

Validating Equipements under Real Production Conditions

Industrial factory photo
Industrial technician conducting quality control on injection and stamping presses in a factory setting.

Validation of tooling, jigs, fixtures and dies must occur under production cadence to reveal fatigue, thermal effects, and tolerance drift.

For regulated products, this pilot phase is usually formalized as IQ OQ PQ process validation, which documents that equipment is installed correctly, runs within its limits and produces conforming parts. IQ and OQ validation of the tooling and fixtures normally precede the pilot batches.

The equipment life expectations vary by process and material; steel injection molds typically range from 100,000 to 1,000,000 cycles depending on steel grade and maintenance (instead of the typically 500 to 2000 if the mold is in aluminum for prototypes or very small run). Progressive press tooling for automotive often exceeds 500,000 strokes with scheduled refurbishments to maintain form accuracy.

Measurement and inspection should be systematic and repeatable. Recommended checks include:

  • Dimensional CMM sampling at planned intervals.
  • Surface roughness and visual wear audits.
  • Torque and clamp-force verification on assembly jigs.

Fixture repeatability targets depend on product tolerance classes; many consumer assemblies require locator repeatability of ±0.05–0.2 mm. Calibrated power tools used for fastening should maintain torque within ±5% of setpoint, verified by a traceable calibration regimen.

MethodTypical frequencyProsCons
Visual + checklistShiftlyFast, low costSubjective, misses subsurface faults
CMM / metrologyDaily or batchHigh accuracySlower, equipment needed
NDT (dye penetrant/ultrasonic)ScheduledDetects crackingRequires prep, skilled operator

A practical sample size for initial capability estimation is often 30 parts per critical feature.

Documented wear thresholds, an itemized corrective action plan, and controlled design changes must be enforced when drift exceeds limits.

Tip: correlate cycle count with measured wear and add a preventive maintenance stop at 60–80% of predicted die life to avoid unplanned failure.

PPAP highlight: the Production Part Approval Process (PPAP) is an essential system in the automotive sector aimed at building trust in suppliers and their production methods. Its main goal is to confirm that a supplier can consistently meet the quality and manufacturability standards for the parts they deliver. PPAP ensures that suppliers have a clear understanding of the customer’s design specifications and expectations.

It also confirms that the supplier’s manufacturing process can reliably produce parts that meet these standards during full-scale production at the agreed rate (see R@R below).

This standardized process supports clear communication and approval of production methods and designs before, during, and after manufacturing.

A full PPAP submission can consist of 18 elements that collectively demonstrate a supplier’s ability to satisfy customer requirements. These elements include design documentation, records of engineering changes, and approvals from customer engineering. The submission also features detailed evaluations such as Design Failure Mode and Effects Analysis (DFMEA), Process Flow Diagrams, and Process Failure Mode and Effects Analysis (PFMEA). Other components include a Control Plan, studies of measurement system accuracy, and results from a representative production run. The entire submission is compiled and summarized in a Part Submission Warrant (PSW). There are five PPAP submission levels, ranging from Level 1, which includes only the PSW, to Level 5, which requires full documentation and product samples ready for on-site review at the supplier’s facility.



R@R highlight: together with the PPAP, the Run at Rate (R@R) is part of the pre-production assessment in the automotive industry used to confirm that a supplier’s manufacturing process can consistently produce the required volume of parts at the agreed-upon production rate while meeting quality standards. This evaluation is usually performed at the supplier’s site and often observed by the customer to replicate actual production conditions. During the Run at Rate, critical metrics such as cycle time, output levels, and scrap rates are carefully tracked to uncover any inefficiencies or quality concerns before full-scale production begins. A successful Run at Rate indicates the supplier’s readiness for the Start of Production (SOP) and their ability to reliably meet the manufacturer’s production and quality expectations. This process verifies the production capacity outlined in the Production Part Approval Process (PPAP) submission and helps reduce the risk of future supply chain issues.



Pilot feedback
Finalizing product design processes through pilot feedback and quality control documentation.

Finalizing Processes from Pilot Feedback

Pilot feedback is used to finalize work instructions, quality control plans, and traceability trees. Work instructions document purpose, scope, tools, step sequence, and acceptance criteria. ISO 13485 requires documented production procedures and FDA 21 CFR 820 mandates device master records. Use controlled revision numbering and operator sign-off for each change.

Traceability
Ensuring traceability and corrective actions in automotive product design through structured analysis and documentation.

Quality control plans must list critical characteristics, sampling, and inspection methods. Apply ANSI/ASQ Z1.4 or ISO 2859-1 sampling tables for lot-based inspection. For electronics, process capability of Cpk ≥ 1.33 is commonly targeted.

Traceability records must connect serialized units to component lots and process parameters. MES, barcode, or RFID implementations create immutable timestamps and audit trails. Automotive PPAP submissions require material traceability and process records for approval.

Pilot-run corrective action uses containment, investigation, root cause, correction, and verification steps. Common tools include 8D reports and the 5 Whys technique for structured root cause analysis.

Documented outcome metrics must be tracked until stability is established:

  • Containment verification
  • Corrective action recorded
  • Effectiveness check after three production shifts

Establish signatory authority, change-control gates, and release checklists before mass release. Use the following comparison to align documents and verification methods.

DocumentPurposeVerification Method
Work InstructionStep-by-step assembly and acceptance criteriaOperator sign-off and observation
QC PlanSampling, test methods, acceptance levelsLot inspections and statistical reports
TraceabilityComponent genealogy and lot historySerialized records and MES audit trail

Tip: retain pilot trace logs for at least two times the longest component shelf life. Note: you industry or notified body may have mandatory rules for these.

Formal go/no-go & Industry Specific Release Requirements

Industrial factory floor
Engineers conducting a formal release review on an industrial factory floor.

Establish measurable go/no-go thresholds covering quality, throughput, and compliance. Typical thresholds include first pass yield, Cpk, and functional test pass rate. Decision criteria must include documented sign offs and corrective action closure evidence.

Consumer electronics releases require regulatory markings and full functional verification. CE marking, UL listing, and EMC compliance are standard milestones. For injection molded parts, dimensional capability and visual acceptance often use AQL 2.5 percent.

Medical device release mandates documented IQ/OQ/PQ and formal validation protocols. Regulatory frameworks include FDA 21 CFR 820 and ISO 13485 certification. Process validation typically follows three stages, with documented evidence required for each.

Automotive PPAP requires submission of a Part Submission Warrant and supporting data. Deliverables commonly include control plan, FMEA, MSA, dimensional results, and run-at-rate evidence. Automotive programs often require Cpk ≥1.67 for critical characteristics.

IndustryCritical documentsProcess capability target
Consumer electronicsFunctional test reports; CE/UL; EMCCpk ≥1.33
Injection molded plasticsMold trial report; SPC charts; visual AQLCpk ≥1.33
Medical devicesIQ/OQ/PQ; Device Master Record; validation reportCpk ≥1.33
Automotive (PPAP)PSW; control plan; FMEA; MSACpk ≥1.67

Decision gates should map to documented metrics and regulatory deliverables. Refer to the From Lab to Market pilot production run strategic guide for alignment.

Tip: employ a binary decision matrix and require documented customer sign-off before volume release.

Conclusion

Pilot production run
Pilot production run showcasing engineering validation and quality control in a modern industrial setting.

Turning prototype performance into repeatable production requires a methodical pilot run that validates the manufacturing process rather than the product design. A properly executed pilot surfaces tooling wear, assembly bottlenecks and inspection gaps under genuine cycle times and operator conditions, producing the documented evidence the FDA describes:

“Process validation is establishing documented evidence that provides a high degree of assurance that a specific process will consistently produce a product meeting its predetermined specifications and quality attributes.” (FDA Process Validation Guidance, 2011)

By applying targeted metrics -first pass yield, cycle time, scrap rate and process capability- teams convert assumptions into measurable status indicators and prioritize corrective actions that eliminate the most damaging risks before volume launch.

FAQ

What should pilot run objectives concentrate on when moving from prototype to production?

Objectives must confirm the manufacturing process capability, stability, and repeatability rather than revalidating product engineering decisions. Set measurable acceptance criteria for tooling setup, process controls, and assembly methods that will be used in volume production.

How do you choose pilot run quantity, production line, and plant layout?

Select a quantity large enough to capture process variation and perform capability studies, typically determined by sampling plans and expected defect rates. Pick a line and layout representative of the intended mass-production environment, ensuring equipment, material flow, and tooling match planned conditions.

What operator training is required before starting a pilot run?

Provide hands-on training on standard work, critical control points, inspection criteria, and containment procedures with documented competency checks and sign-offs. Conduct run-in sessions to confirm operator consistency and update work steps based on observed deviations.

Which validation metrics should be tracked during the pilot run?

Measure Initial Pass Yield (IPY), cycle time and takt adherence, scrap and rework rates, and process capability indices such as Cp and Cpk to quantify stability and capability. Collect trend data and variation sources so acceptance thresholds and control limits can be set for volume production.

How should tooling, jigs, fixtures, and dies be validated under pilot conditions?

Run tools and fixtures at production cadence to assess wear, dimensional drift, setup repeatability, and maintenance needs while logging failure modes and corrective actions. Use life-cycle data to set preventive maintenance intervals, tool replacement limits, and acceptable tolerances before mass release.

When and how are work instructions, quality plans, and traceability finalized from pilot feedback?

Update step-by-step work instructions, inspection checklists, and control limits based on observed deviations and operator feedback during the pilot, including photographs and critical parameter values. Lock down lot traceability, sampling plans, and corrective-action procedures with documented CAPA workflows and verification criteria prior to production release.

What are formal go/no-go criteria for moving to mass production?

Establish pass thresholds for IPY, sustained Cpk targets, acceptable scrap rates, stable cycle times, completed documentation, and successful supplier readiness checks, then require cross-functional sign-off from manufacturing, quality, and supply chain. Ensure corrective actions from pilot nonconformances are closed and verified before granting release to volume production.

What industry-specific release requirements apply for consumer electronics, injection molded plastics, medical devices, and automotive parts?

Consumer electronics need functional validation, ESD controls, and production verification; injection molded parts require mold qualification, dimensional reporting, and validation of molding cycles and material behavior. Medical devices require process validation with IQ/OQ/PQ and full traceability, while automotive production typically requires PPAP submission with samples, control plans, and capability evidence prior to production approval.



Related Readings

  • Supplier qualification and incoming materials control: pre-qualifying suppliers and setting material acceptance criteria
  • Statistical process control and control-chart deployment: implementing SPC rules and control charts for live process monitoring
  • Environmental and accelerated stress testing on production units: executing thermal, humidity and vibration stress runs during pilot
  • Packaging, kitting and labeling validation under production throughput: verifying package integrity, kitting accuracy and label application at speed
  • Manufacturing execution system (MES) and data-capture integration: connecting machines and operators to capture traceability and analytics
  • Regulatory submissions and audit readiness for pilot data: preparing documentation and evidence from pilot runs for regulatory review
  • Maintenance strategy validation and mean time tracking: validating preventive maintenance intervals and capturing downtime causes
  • Engineering change control (ECO) and documentation flow testing: exercising ECO approvals, revision control and shop-floor distribution
  • Process risk assessment and PFMEA updates: updating PFMEA, control plans and mitigation actions from pilot data
  • Workplace ergonomics and safety assessment: observing operator posture, access and EHS controls under realistic pace
  • Supply chain and inbound logistics rehearsal: running kitting, buffer stocking and just-in-time deliveries to the pilot line
  • Cost of quality analysis and scrap accounting: quantifying rework, scrap costs and inspection labor for ramp economics
  • Firmware and software production deployment and rollback procedures: validating secure flashing, version control and rollback steps in production
  • Line balancing and bottleneck identification with takt time analysis: measuring takt, balancing stations and locating throughput constraints
  • Pilot-run inspection equipment calibration and gauge R&R: calibrating inspection tools and performing gauge repeatability and reproducibility studies



External Links on Pilot Production Run

(hover the link to see our description of the content)

Glossary of Terms Used

Acceptance Quality Limit (AQL): a statistical measure used in quality control to determine the maximum number of defective items acceptable in a sample size during inspection, ensuring that the quality of a batch meets specified standards.

American National Standards Institute (ANSI): a private non-profit organization that oversees the development of voluntary consensus standards for products, services, processes, and systems in the United States, promoting quality, safety, and interoperability across various industries.

Code of Federal Regulations (CFR): a compilation of the general and permanent rules published by federal agencies in the United States, organized by subject matter into 50 titles, serving as the official legal source for federal regulations.

Contract Manufacturer (CM): a company that produces goods on behalf of another firm, typically following specific design and quality specifications. This arrangement allows the hiring company to focus on core competencies such as marketing and product development while outsourcing manufacturing processes.

Corrective Action and Preventative Action (CAPA): a systematic approach to identifying, investigating, and addressing nonconformities and potential issues to prevent recurrence and ensure compliance with regulatory standards in quality management systems.

Corrective and Preventive Action (CAPA): a systematic approach to identifying, investigating, and addressing nonconformities to prevent recurrence and eliminate potential issues, ensuring compliance with regulatory standards and continuous improvement in processes and products.

Cost and Freight (CFR): a shipping agreement where the seller pays for transportation and freight charges to deliver goods to a specified port, while the buyer assumes risk and responsibility for insurance and costs once the goods are loaded onto the vessel.

Cost of Quality (CoQ): total costs associated with ensuring products or services meet quality standards, including prevention, appraisal, and failure costs. It encompasses expenses incurred to avoid defects, costs of evaluating quality, and costs resulting from defects in products or services.

Critical Control Points (CCP): specific stages in a process where control can be applied to prevent, eliminate, or reduce food safety hazards to acceptable levels. Identifying these points is essential for effective hazard analysis and critical control management in food production systems.

Defects Per Million Opportunities (DPMO): a measurement used in quality control that quantifies the number of defects in a process per one million opportunities for error, calculated by dividing the number of defects by the total number of opportunities and multiplying by one million.

Design Failure Mode and Effects (DFMEA): a systematic approach for identifying potential design-related failures, analyzing their effects on system performance, and prioritizing risks to enhance product reliability and safety during the design phase.

Design for Manufacturability (DFM): a set of engineering practices aimed at designing products to simplify and optimize the manufacturing process, reducing production costs, improving quality, and minimizing time to market by considering manufacturing capabilities and constraints during the design phase.

Device Master Record (DMR): a compilation of documents and specifications that provide the necessary information to produce a medical device, including design specifications, production processes, quality assurance measures, and labeling requirements, ensuring compliance with regulatory standards.

Eight Disciplines Problem Solving (8D): a structured problem-solving methodology used to identify, correct, and eliminate recurring issues, consisting of eight steps: team formation, problem description, containment actions, root cause analysis, corrective actions, implementation, prevention, and recognition of team efforts.

Electromagnetic Compatibility (EMC): the ability of electrical devices to operate without interference from external electromagnetic fields and to not emit levels of electromagnetic energy that cause interference to other devices.

Electrostatic Discharge (ESD): a sudden flow of electricity between two electrically charged objects caused by contact, an electrical short, or dielectric breakdown. It can damage electronic components and disrupt electronic systems.

Engineering Change Order (ECO): a document that authorizes modifications to a product's design, specifications, or processes, detailing the changes, reasons, and implementation instructions, ensuring proper tracking and management of alterations throughout the product lifecycle.

Failure Mode and Effects Analysis (FMEA): a systematic method for evaluating potential failure modes within a system, process, or product, assessing their effects on performance, and prioritizing risks to improve reliability and safety through corrective actions.

First Article Inspection (FAI): a quality assurance process that verifies a manufacturer's production process by inspecting the first item produced against specified requirements, ensuring compliance with design specifications and standards before mass production begins.

First Pass Yield (FPY): a manufacturing metric that measures the percentage of products produced correctly without rework or defects during the initial production process, indicating efficiency and quality in operations.

Food and Drug Administration (FDA): a federal agency of the United States Department of Health and Human Services responsible for regulating food safety, pharmaceuticals, medical devices, cosmetics, and tobacco products to ensure public health and safety through scientific evaluation and enforcement of compliance standards.

Installation Qualification (IQ): a documented process to verify that equipment or systems are installed according to specifications, including assessment of utilities, environmental conditions, and compliance with design requirements, ensuring readiness for operational qualification.

International Organization for Standardization (ISO): a non-governmental international body that develops and publishes standards to ensure quality, safety, efficiency, and interoperability across various industries and sectors, facilitating global trade and cooperation. Established in 1947, it comprises national standardization organizations from member countries.

Just-In-Time (JIT): a production strategy that reduces inventory costs by scheduling materials and components to arrive precisely when needed in the manufacturing process, minimizing waste and enhancing efficiency.

Manufacturing Execution System (MES): a software solution that monitors, controls, and optimizes production processes in real-time, facilitating data collection, tracking of manufacturing operations, and integration with enterprise systems to enhance efficiency and productivity on the shop floor.

Measurement System Analysis (MSA): a statistical method used to evaluate the accuracy, precision, and reliability of measurement processes and instruments, ensuring that data collected is valid and consistent for decision-making in quality control and process improvement.

Non-Destructive Testing (NDT): a method used to evaluate material properties, integrity, or structure without causing damage, employing techniques such as ultrasonic, radiographic, magnetic particle, and dye penetrant testing to detect flaws or discontinuities.

Operational Qualification (OQ): a validation process that ensures equipment or systems operate according to specified requirements within defined limits, confirming that they perform as intended in their operational environment.

Performance Qualification (PQ): a process that verifies a system or equipment operates according to specified requirements under real-world conditions, ensuring it consistently performs its intended function within predetermined limits.

Process Capability Index (Cpk): a statistical measure that quantifies how well a process can produce output within specified limits, indicating the relationship between the process mean and the nearest specification limit, adjusted for process variability.

Process Failure Mode and Effects Analysis (PFMEA): a systematic method for identifying and evaluating potential failures in a manufacturing or business process, assessing their effects on outcomes, and prioritizing actions to mitigate risks.

Production Part Approval Process (PPAP): a standardized procedure used in manufacturing to ensure that suppliers meet quality requirements before mass production, involving documentation and validation of design specifications, process capabilities, and production samples to confirm compliance with customer expectations.

Project Management Office (PMO): a centralized entity within an organization that standardizes project management practices, provides governance, supports project execution, and facilitates resource allocation to ensure alignment with strategic objectives and improve project outcomes.

Repeatability and Reproducibility (R&R): a measurement system's ability to produce consistent results under the same conditions (repeatability) and across different conditions or operators (reproducibility), often evaluated through statistical methods to assess variability and reliability in data collection processes.

Root Cause Analysis (RCA): a systematic process for identifying the fundamental factors that lead to a problem or failure, aiming to address and eliminate the underlying issues rather than merely treating symptoms.

Standard Operating Procedure (SOP): a set of step-by-step instructions created to help workers carry out routine operations consistently and efficiently, ensuring compliance with regulations and quality standards.

Statistical Process Control (SPC): a method of quality control that employs statistical techniques to monitor and control a process, ensuring it operates at its full potential by identifying variations and maintaining consistent output within specified limits.

Takt Time: the maximum allowable time to produce a product to meet customer demand, calculated by dividing available production time by required output. It helps synchronize production pace with demand, ensuring efficient workflow and resource allocation.

Topics covered: Pilot production run, process validation, tooling validation, assembly processes, quality control, First Pass Yield, cycle time, scrap rate, process capability, inspection plans, traceability, corrective actions, manufacturing capability, Go/No-Go decision criteria, regulatory release checklists, IQ/OQ/PQ, PPAP, and ANSI/ASQ Z14..

Historical Context

1950
1955
1956
1960
1960
1960
1960
1950
1950
1955
1958
1960
1960
1960
1960

(if date is unknown or not relevant, e.g. "fluid mechanics", a rounded estimation of its notable emergence is provided)

10th year anniversary

Full size images and downloads are only available, 100% free, for registered members.

> Login <
